Parnassus Heights Monthly Construction Update | July and August 2025

About This Monthly Construction Update

UCSF Real Estate shares Parnassus Heights construction updates monthly. Updates will be sent to the UCSF Parnassus Heights community on the Monday following the first of each month and will be posted online. This special summer issue combines July and August 2025 updates. Dates and details are subject to change.


UCSF Health Helen Diller Hospital

To serve the city with world-class care for the next century, UCSF is constructing the UCSF Health Helen Diller Hospital (HDH). The 15-story hospital at the Parnassus Heights campus is being constructed on the former Langley Porter Psychiatric Hospital site through 2029, with the new hospital expected to open in 2030.


Progress Taking Shape with Foundation Milestones for HDH

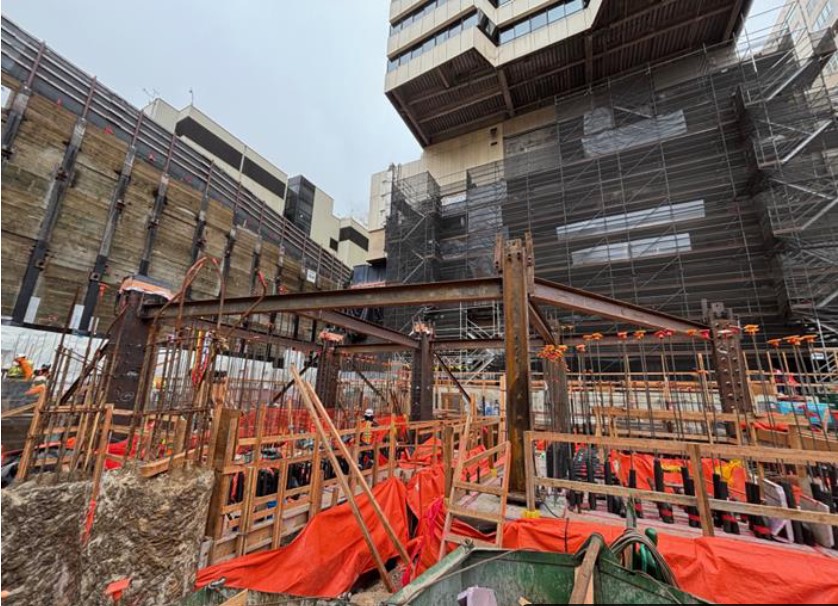

First placement of steel for the steel elevator pit on the Helen Diller Hospital site.
First placement of steel for the steel elevator pit on the Helen Diller Hospital site.

Significant progress continues on the HDH project site, with major foundation milestones recently completed. Several concrete placements have been successfully completed overnight. Through 2025, these concrete pours will occur from 11 p.m. to 8 a.m. during weekdays. Due to the heat generated during concrete curing, these pours must take place overnight during cooler weather conditions to ensure structural integrity.

To prepare for the hospital’s massive structural demands, steel box column mock-ups —designed to help the building support heavy vertical loads — were successfully completed in Mexico. These early prototypes play a key role in ensuring quality and precision as the project moves into its next major construction phase.

Crews are also focused on seismic damper testing, the layout and installation of 3.6 million pounds of rebar, and construction for future connections between the new and existing hospitals. Progress continues with critical underground electrical infrastructure.

The HDH project recently completed the first placement of steel in the building’s elevator area, marking a key moment in vertical construction. Looking ahead, the main steel erection is slated to begin in late 2025, signaling a major construction phase as the new hospital building project begins to rise above ground.

Video: Second Tower Crane Installed at HDH Construction Site

This video shows the successful installation of a second tower crane at the UCSF Health Helen Diller Hospital (HDH) construction site at Parnassus Heights, marking continued progress on the 15-story hospital scheduled to open in 2030.

The first tower crane — standing 279 feet tall — was installed near Parnassus Avenue in March 2025. The newly added 262-foot-tall crane, located adjacent to the existing hospital and installed in May 2025, will support the next phase of work as the building’s steel superstructure begins rising later in 2025. Together, both cranes will play a vital role in constructing the hospital, which is expected to be completed in 2029, with the first patient in 2030.



Construction Continues for Future Connections to Long Hospital

Construction continues to create openings on the east side of Long Hospital in preparation for future connections to the new hospital. This construction includes saw cutting and chipping the wall. This work must be completed before structural steel erection begins at the end of 2025.

The UCSF Community can read more about this work and its expected impacts for the existing hospital and UCSF community in the Manager Toolkit. (UCSF MyAccess required).

Impacts and Mitigations

  • Noise: Consistent chipping noise expected Monday - Saturday, 8 a.m.- 8 p.m.
  • Area Impacts: Specific patient care and staff spaces will be affected at different stages of the work.
  • Coordination: Mitigation plans have been developed in partnership with hospital leadership.
  • Support: To escalate an issue, please contact your department manager.
Construction is underway for a connection between the existing and new hospitals at Parnassus Heights.
Construction is underway for a connection between the existing and new hospitals at Parnassus Heights.




UCSF Barbara and Gerson Bakar Research and Academic Building

Construction is underway at Parnassus Heights for the UCSF Barbara and Gerson Bakar Research and Academic Building (BRAB), a state-of-the-art building that will create a vital collaborative space that drives innovations in scientific research and education. BRAB will house the UCSF School of Nursing and research programs for cancer, microbiology, diabetes, immunology, and cell biology. BRAB is expected to be completed in 2027, with occupancy in 2028.


BRAB Structural Steel Reaches Maximum Height

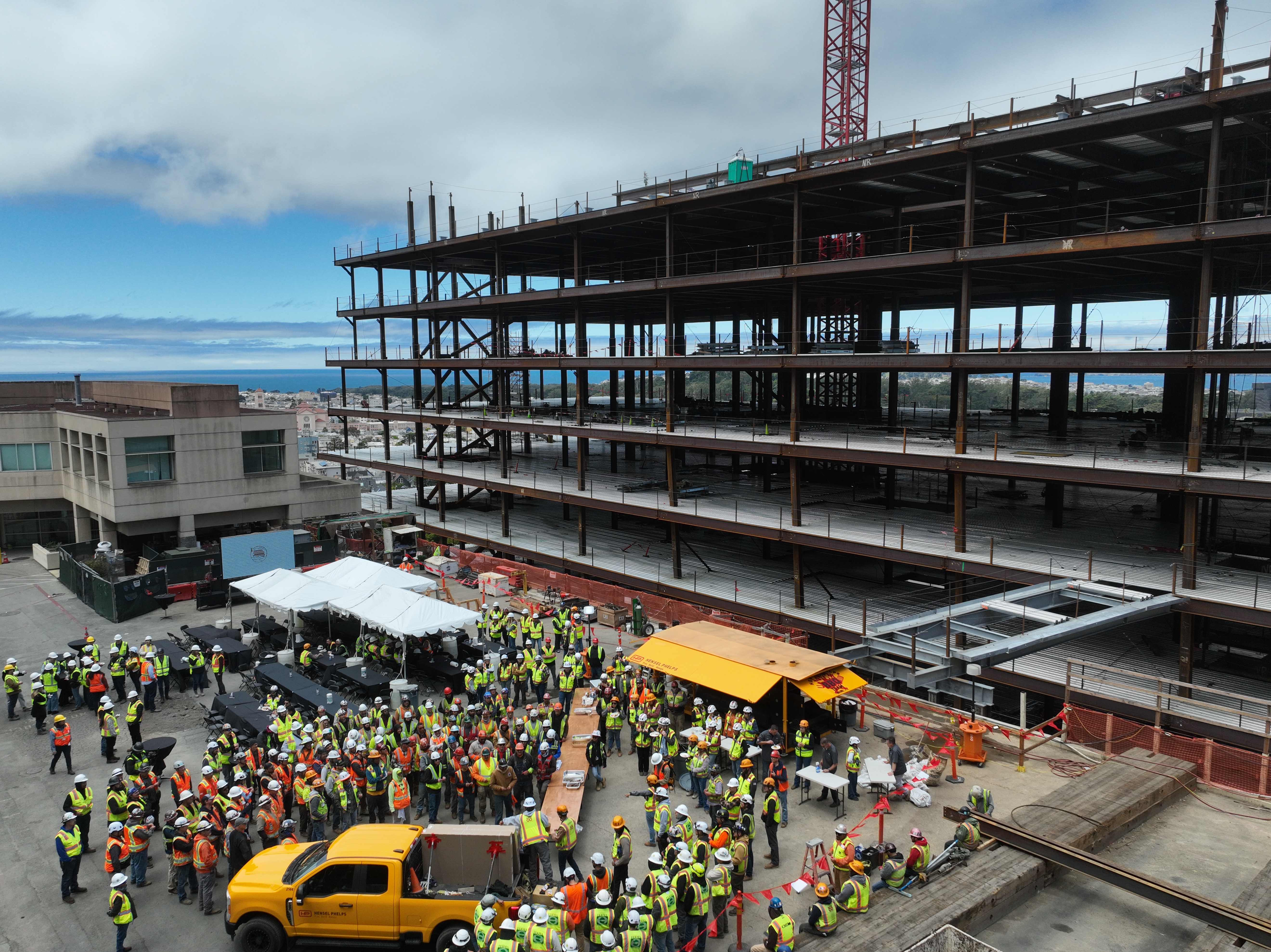

The Bakar Research and Academic Building construction team celebrated a milestone on July 16, 2025, with the structure reaching its maximum height.
The Bakar Research and Academic Building construction team celebrated a milestone on July 16, 2025, with the structure reaching its maximum height in July 2025. Structural steel will continue to be building out through the end of 2025.

The BRAB construction team celebrated a major milestone with the completion of metal deck installation through level 10, signifying that the structure has reached its maximum height. Hundreds of construction workers participated in a ceremony on July 16, 2025, to acknowledge their hard work and dedication in keeping the construction on schedule for the building's opening in early 2028. The event attendees signed a steel beam at the site that was lifted – with an American flag and an evergreen tree – and installed atop the building. The practice has roots in Scandinavian and Native American traditions, with the tree symbolizing growth, good luck, and respect for the land and workers.

“This magnificent structure stands before us as a testament to the tremendous technical, physical, and logistical work of so many people,” said Ron Blaj, Director of Major Capital Projects for UCSF Real Estate Campus Design & Construction, at the event.

Structural steel will continue to be built out through the end of the year. Additional phases of construction underway include finalizing the floor decking, followed by elevated deck concrete placements.

On the ground level, site activity continues to intensify, with ongoing utility excavation and electrical infrastructure work in the southern portion of the site. Material deliveries remain steady along Koret Way, in addition to Parnassus Avenue near Fourth Avenue.

BRAB Construction Facts as of July 16, 2025:

  • 871 working days completed
  • 4,704 steel beams installed (~3,208 tons)
  • 83,363 linear feet of steel
  • 1,100 cubic yards of concrete poured
  • 164 shoring piles and 177 building piles with an average depth of 65 linear feet
Impacts and Mitigations
  • Noise is expected from steel installation and metal deck placements.
  • Early morning concrete pours will continue through March 2026, with two large pours per level each month. Miscellaneous concrete work will occur during standard construction hours, with some pours extending to 9 p.m. on select days.
Time-lapse Video: BRAB Reaches Structural Milestone

Construction on the BRAB site at Parnassus Heights reached a meaningful milestone in July 2025 with the completion of metal deck installation through level 10, marking the structure’s full height. The building will have nine accessible floors. In under a minute, this time-lapse video shows the construction of the project from March 2023 through early July 2025, when the structure reached its full height milestone.



Construction for BRAB Connection to CSB on Level 7 | Late July 2025

In the Clinical Sciences Building (CSB), additional construction is scheduled to start in late July 2025 on level 7 for a connection from CSB to BRAB. The bridge will support creating a connected Research Artery between the new BRAB, CSB, and the Medical Sciences Building (MSB), providing additional collaboration space for the Research Program. Plans are underway for the future interior design of CSB Level 7 north.

Impacts and Mitigations for CSB Occupants

  • Late July 2025: Installation of the bridge on the west side of CSB on level 7 is expected. CSB occupants can expect noise and vibrations.
  • Early 2026: Construction is expected in the southwest corner of CSB level 7 to install windows. Expect noise and material being hauled in and out of CSB.
  • Construction hours for these activities will be from 7 a.m. to 5 p.m. Monday through Friday, with occasional work occurring within the Environmental Impact Report (EIR) hours on the weekends.
  • ‌Dates and details are subject to change.
Construction is underway on level 7 of the Clinical Sciences Building for a connection to the Bakar Research and Academic Building
Construction is ongoing on level 7 of the Clinical Sciences Building for a connection to the Bakar Research and Academic Building.



Rendering of the connecting bridge between the Clinical Sciences Building and the Bakar Research and Academic Building.
Rendering of the connecting bridge between the Clinical Sciences Building (CSB) and the Bakar Research and Academic Building (BRAB).




Parnassus Central Campus Site Improvements

UCSF is embarking on an important endeavor to create a welcoming space that will lead to the “heart of campus” at Parnassus Heights. The Parnassus Central Campus Site Improvements (PCCSI) program will provide extensive site improvements in the central core of the Parnassus Heights campus, where the School of Nursing building currently exists. The project is expected to be completed in 2027.


SON Building Closure Completed as PCCSI Construction Accelerates

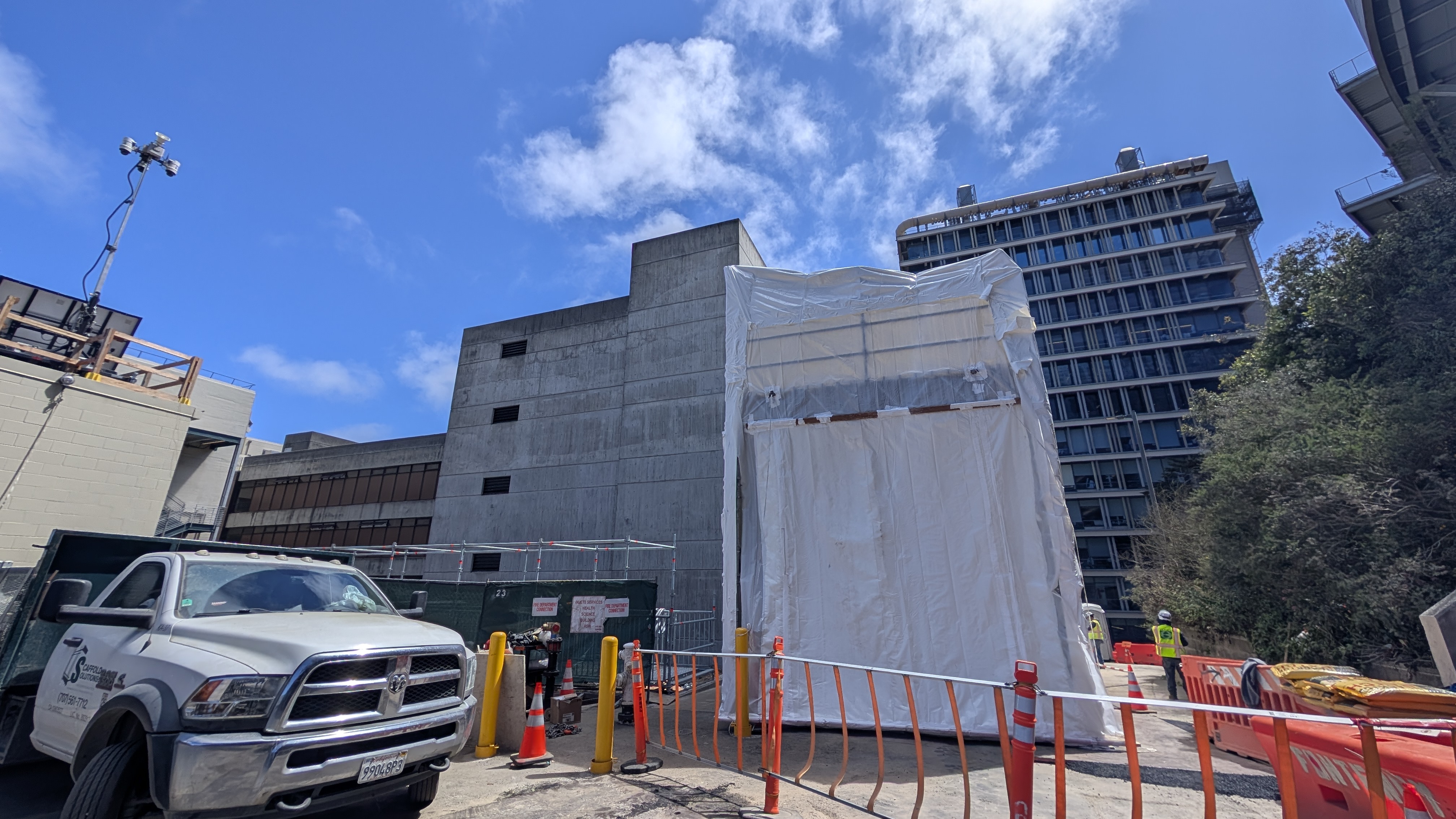

Containment for debris being removed from the School of Nursing building.
Containment area for debris removal during demolition of the School of Nursing building.

Last month, following relocation of Custodial Services to Millberry Union, the School of Nursing (SON) building officially closed to all occupants. After the closure, crews began utility disconnection work — including electricity, water, gas, and high-pressure steam — as part of the transition to full-scale construction for the building’s abatement and eventual demolition.

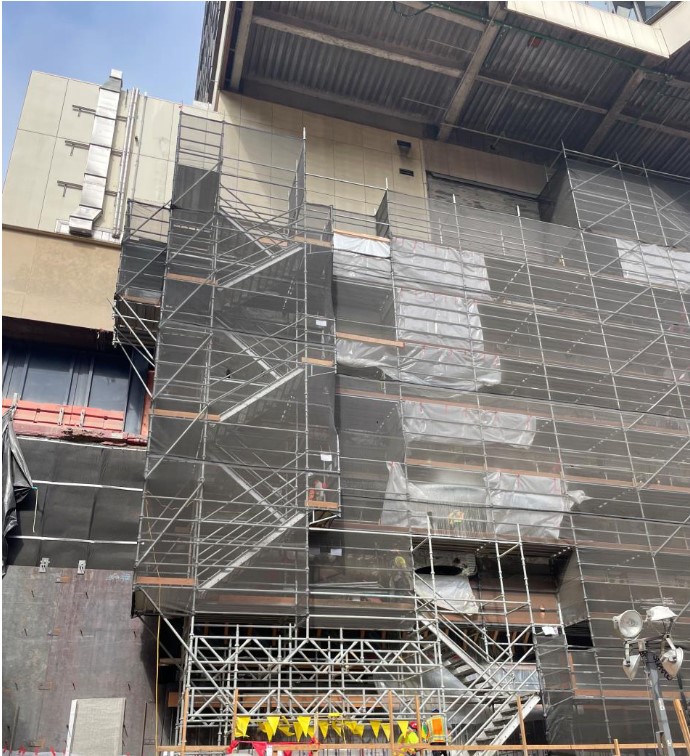

Work is underway on the west side of the building to construct a new exterior emergency egress route for the Clinical Sciences Building (CSB), which will replace the interior exit path that currently runs through the SON building. The new egress route is for emergency use only and is expected to go live in the next two weeks. CSB building occupants will be notified once the date is confirmed. In addition, electrical trenching is nearing completion in front of Saunders Court on the building’s west side. Please observe revised fencing and wayfinding signage around the building as pedestrian access is being maintained on the east side of Saunders Court.

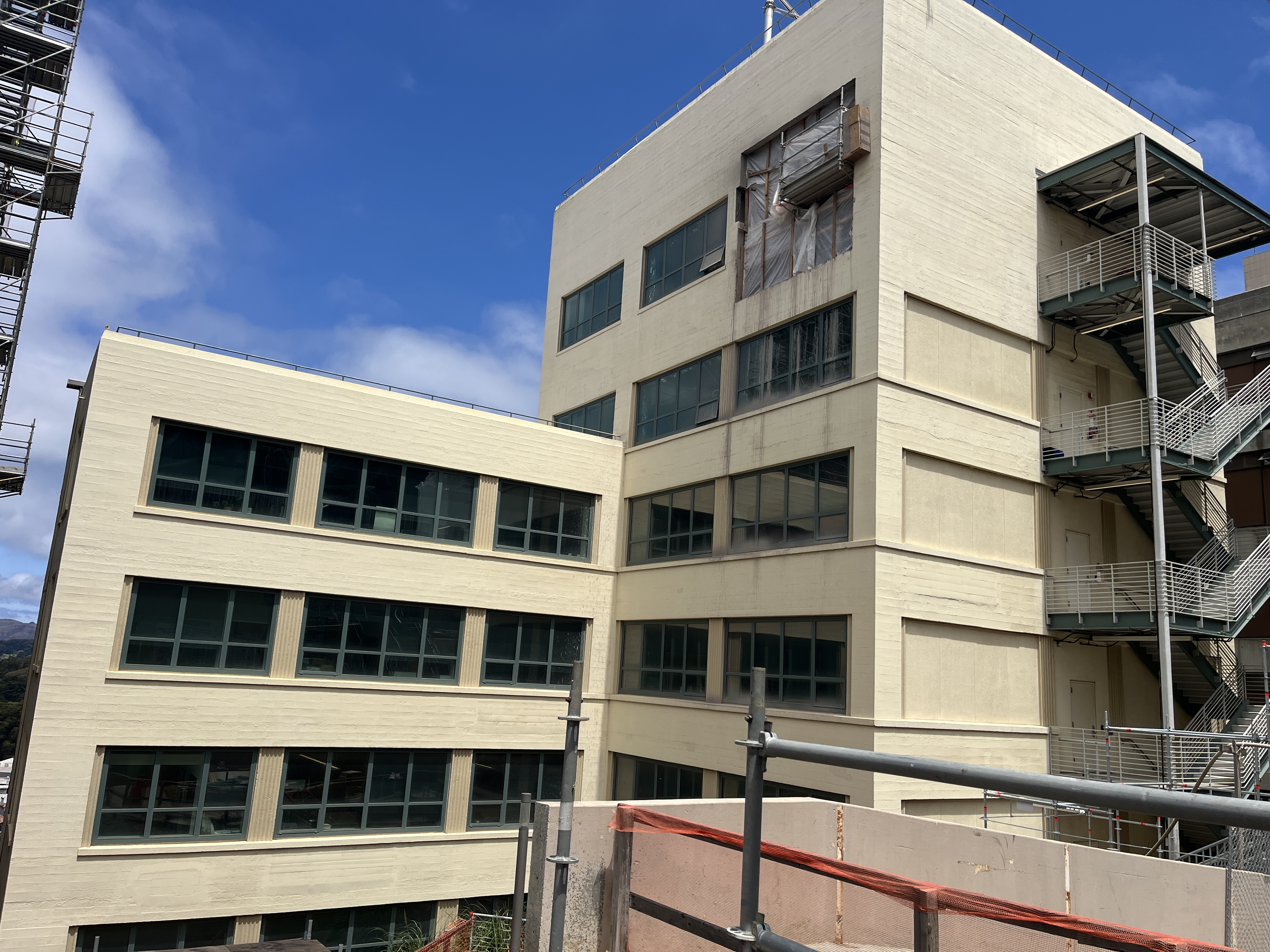

Inside the SON building, floor-by-floor abatement is underway and is expected to be completed in fall 2025. In early August, the team is expected to start removing select exterior caulking materials around the building’s windows and doors, which will require concrete removal activities over several weeks. Exterior demolition of the building is expected to start in late 2025.

Impacts and Mitigations | Construction Site Map
  • Access to the SON building is closed completely.
  • Revised fencing around the SON building.
  • Presence of construction equipment, scaffolding, and crews in and around the building.
  • Expect construction noise during day hours.
  • ‌Dates and details are subject to change.

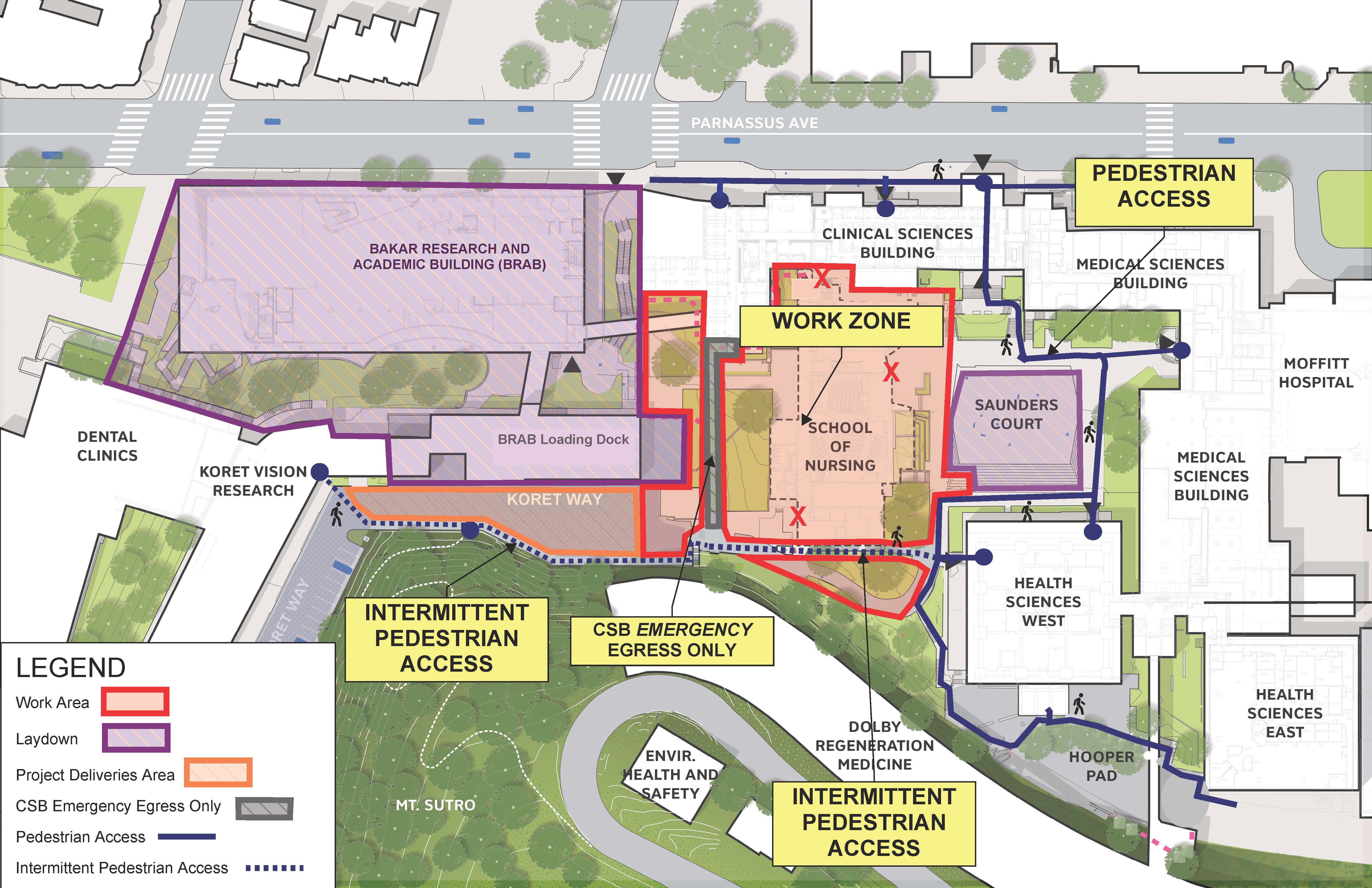

Construction site map for the Parnassus Central Campus Site Improvements Project as of July and August 2025.
Construction site map for the Parnassus Central Campus Site Improvements Project as of July and August 2025.



Koret Way Pedestrian Intermittent Access Through 2025

A‌s the PCCSI project ramps up abatement and demolition, as a safety precaution, these activities will extend the Koret Way closure with intermittent pedestrian access throughout the day, continuing through the end of the year.

Koret Way Daily Access Schedule for PCCSI Construction | Monday through Friday in 2025

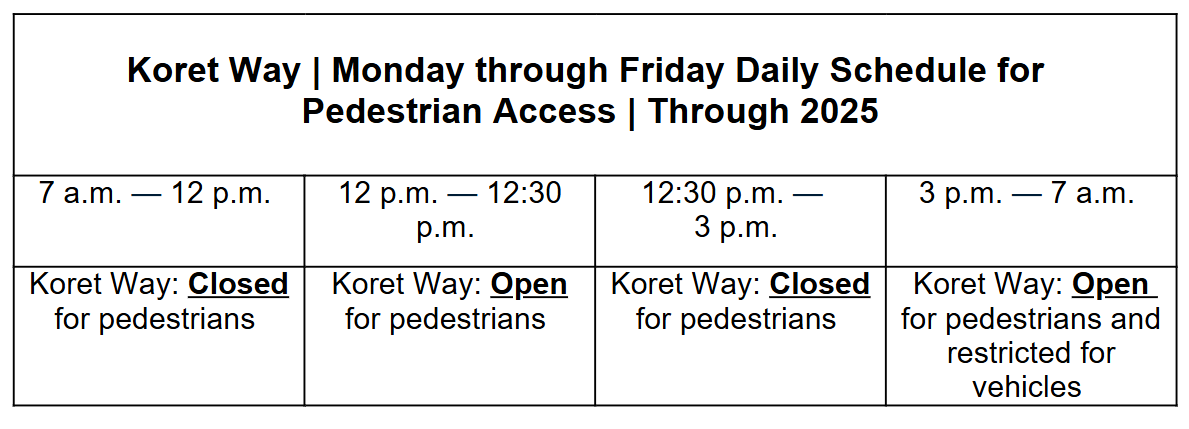

Koret Way Schedule for Pedestrian Access for Monday through Friday through 2025 during PCCSI construction.



Ladle & Leaf Reopening in Late Summer at Millberry Union

The Ladle & Leaf cafe temporarily closed last month as part of the transition to vacate the School of Nursing (SON) building. The cafe is preparing to reopen in late summer 2025 in a newly renovated space on the first floor of Millberry Union, room 135.

An exact reopening date will be announced soon.

The move supports the PCCSI project and the broader campus revitalization effort. Ladle & Leaf and Facilities Services were the last remaining tenants on level 2 of the SON building. Other occupants in the building, including the School of Nursing, which previously relocated.

The new Ladle & Leaf space will offer a refreshed dining experience, featuring warm, natural finishes, expanded seating, and views overlooking the Golden Gate Bridge and the surrounding neighborhood.

  • New Location: Millberry Union, room 135
  • Anticipated Reopening: Late Summer 2025
  • Renovation Impacts and Mitigations: Construction in Millberry Union is ongoing, but minimal disruptions are expected to adjacent spaces.
